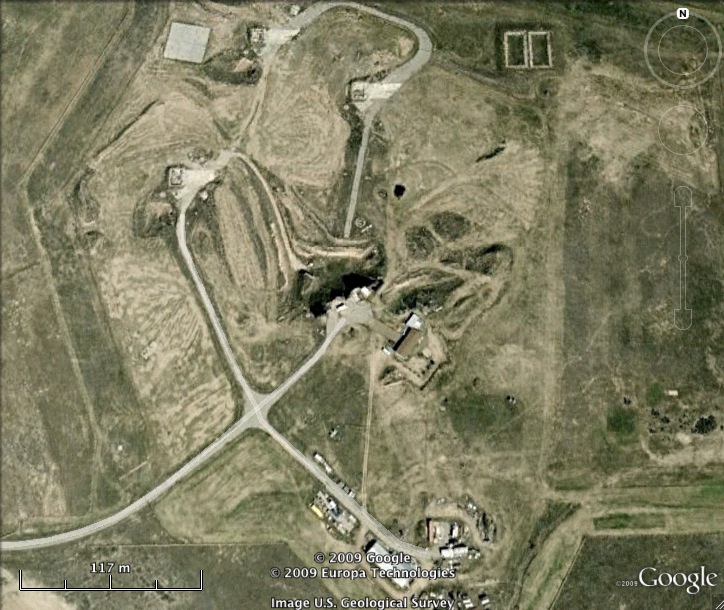

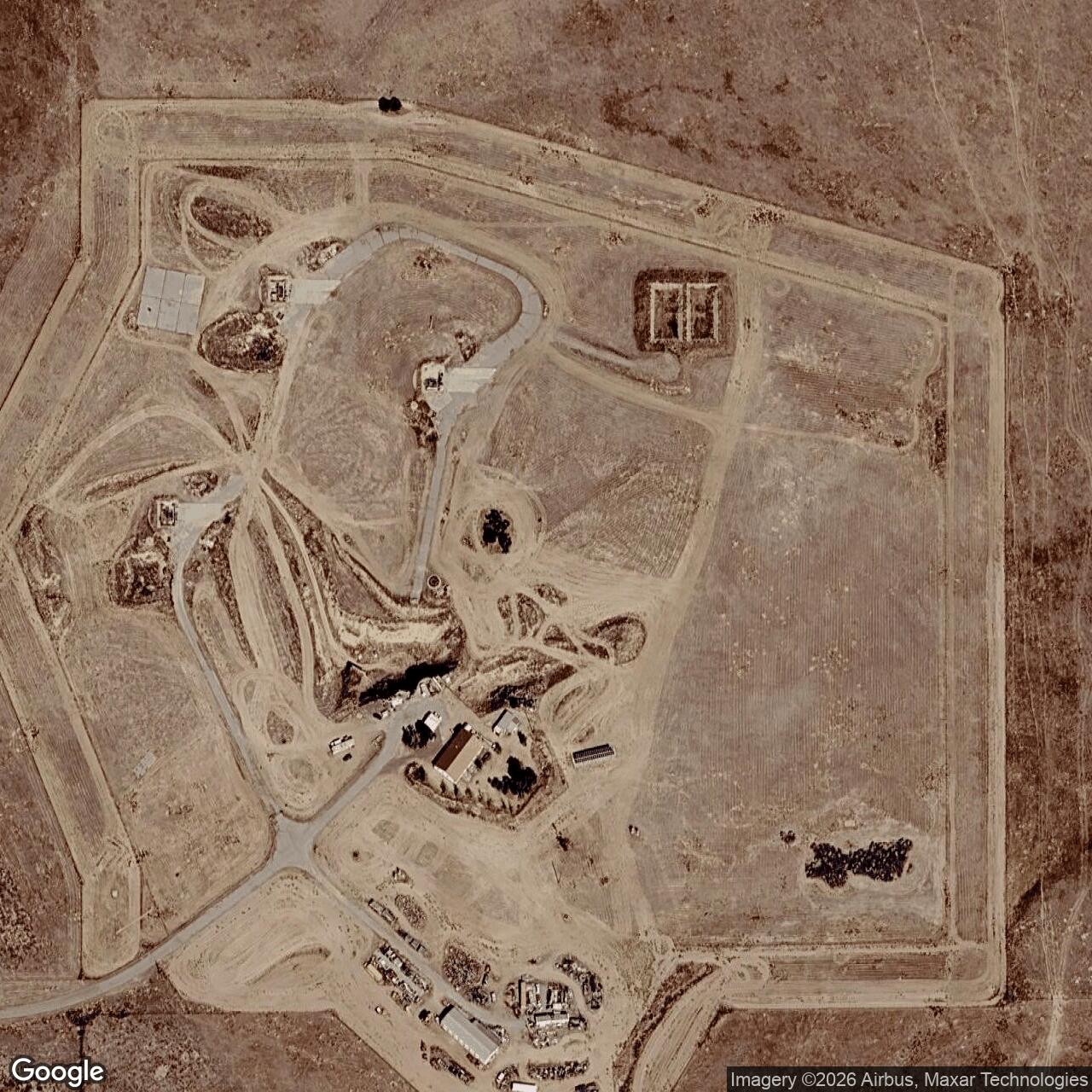

Titan I 569-C
Squadron: 569th SMS
Date Activated: June 1st 1961
Date Deactivated: June 25th 1965
Air Force Base: Mountain Home
State: Idaho
Nearest Town: Boise
Coordinates:
Latitude: 43°20'43.90"N
Longitude: 115°59'31.06"W
Decimal:
3 silos
Former Titan I Missile Complex with the 569th Strategic Missile Squadron
Read about the Titan I at Mountain Home AFB
List of all Titan I site Coordinates
Detailed information about the Titan I Intercontinental Ballistic Missile can be found here.

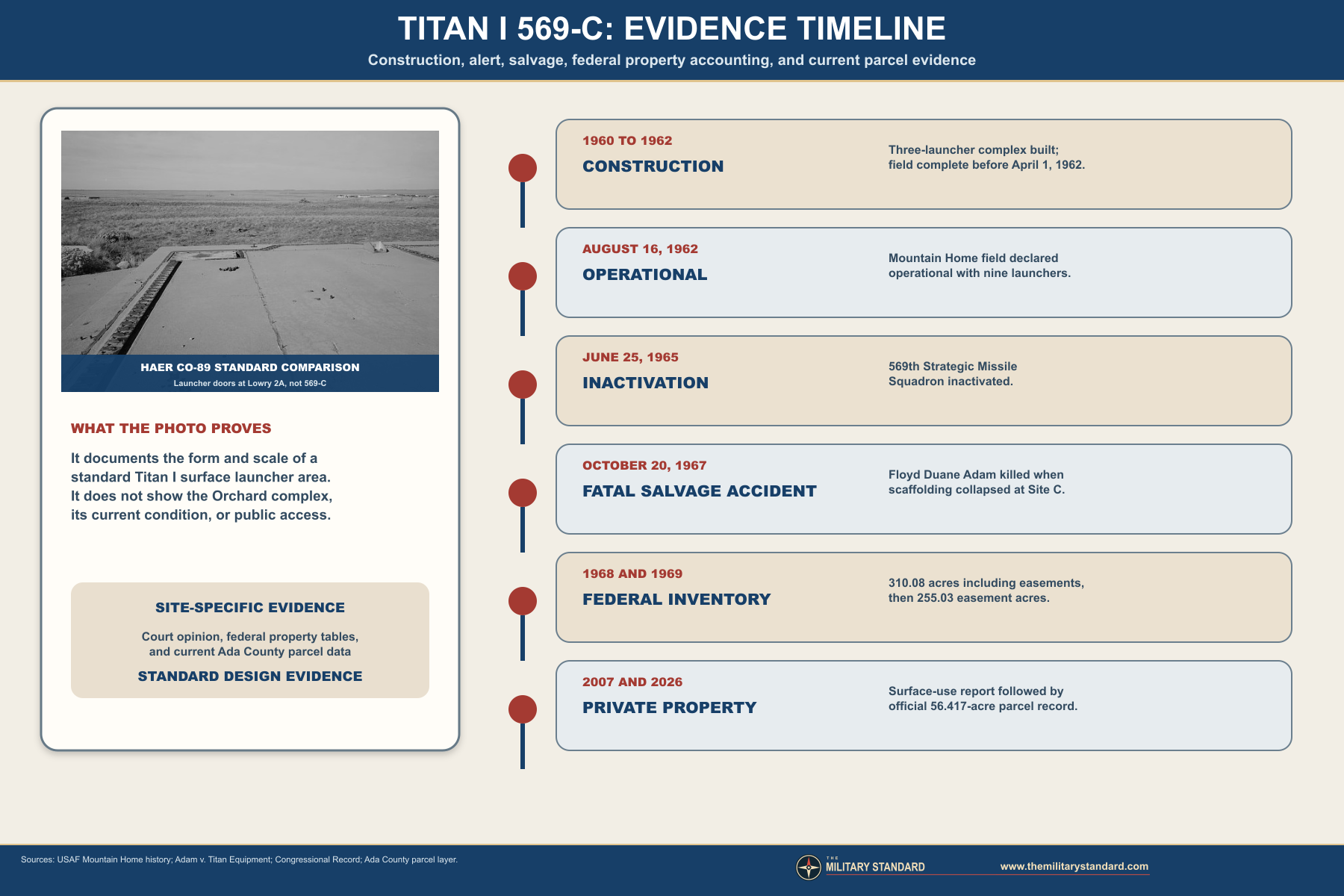

The military career was short but operationally complete. Construction began in 1960, the three-site field was complete before April 1, 1962, first missiles arrived in April, and the field was publicly declared operational on August 16, 1962. The 569th stood alert during the Cuban Missile Crisis. Titan I then yielded to faster, simpler, and more survivable Titan II and Minuteman systems. The 569th was inactivated on June 25, 1965.
Site C's postmilitary record is distinct from the regulated waste histories at Mountain Home Sites A and B. Government records placed the Orchard property in federal surplus inventory, private contractors salvaged its equipment, and an Idaho Supreme Court opinion documents a fatal scaffolding collapse during salvage on October 20, 1967. Federal reports then show the real-property accounting narrowing from 310.08 acres, including 255.03 acres of easements, at the end of 1968 to 255.03 acres of easements at the end of 1969.
The current official parcel record does not reproduce the entire Cold War acquisition. Ada County parcel S2709336100 contains the representative complex point and reports 56.417 acres for property year 2026. The parcel is privately owned. A 2007 Associated Press account described a private residence, vehicles, tires, and earth mounds, but a current interior survey or structural assessment was not located.

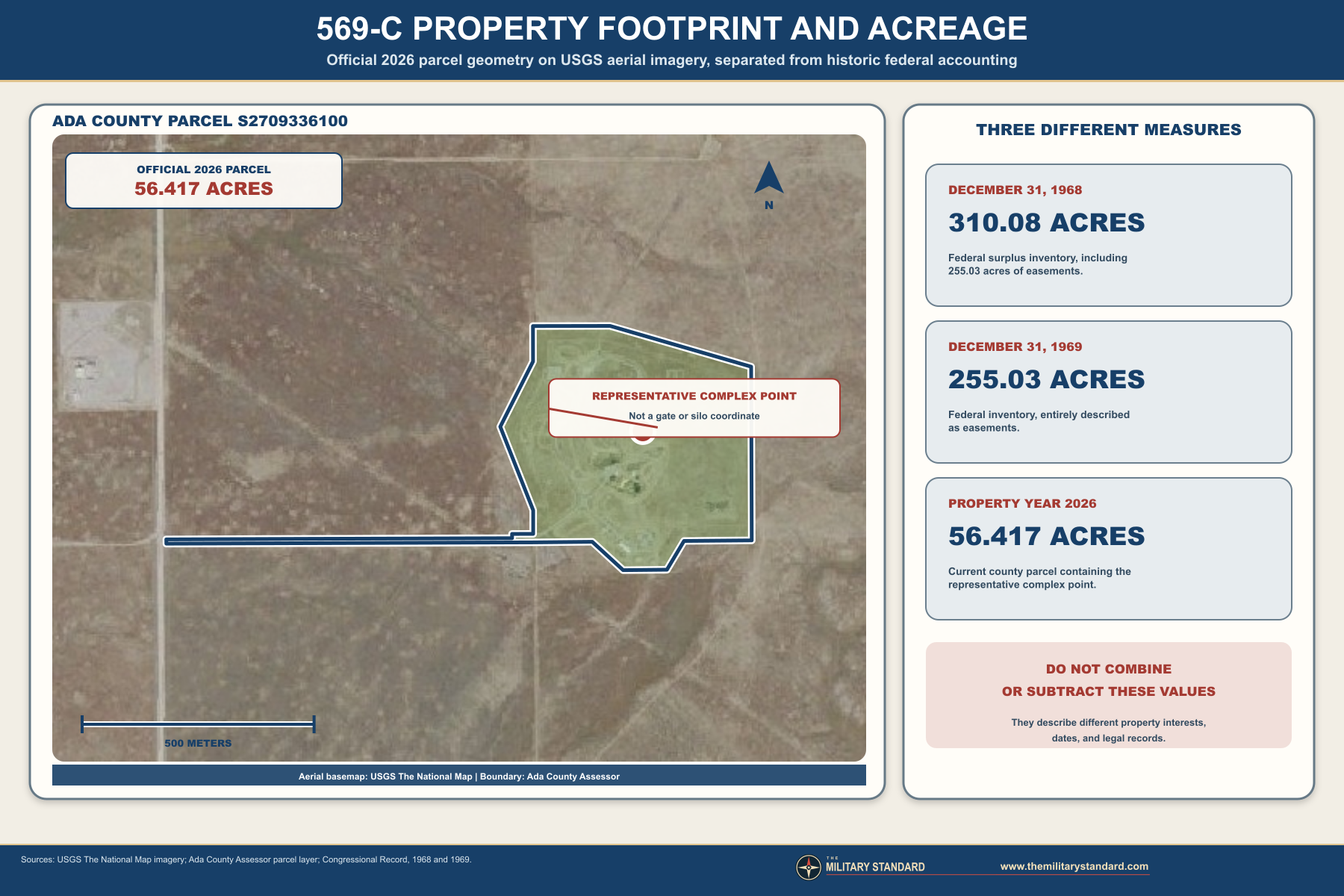

Ada County reports 56.417 acres for the current parcel. Its legal description includes portions of Sections 8, 9, and 16, Township 1 South, Range 4 East, and identifies Parcel A on Record of Survey 14777. The county layer uses Boise as the situs city and RP zoning. This is a current tax-parcel record, not an original Air Force acquisition map or a complete title opinion.
The federal surplus-property record preserves a different footprint. As of December 31, 1968, D-Idaho-457 was listed at 310.08 acres, including 255.03 acres of easements. As of December 31, 1969, the listing showed 255.03 acres and specified that the entire amount consisted of easements. The most reasonable interpretation is that the fee or other non-easement portion had left the federal inventory while easement interests remained, but that conclusion is an inference from successive reports rather than a deed-by-deed chain of title.
The current parcel, original security area, fee tracts, utility corridors, road interests, communications routes, and federal easements may overlap without being identical. No graphic or acreage value in this history merges them. Recorded deeds, easement instruments, and a professional survey control legal boundaries.
Dispersal was a strategic design choice. Separating the three complexes reduced the chance that one attack could destroy all nine Mountain Home missiles. Distance also imposed daily operating costs. Crews, security forces, maintainers, inspectors, contractors, supplies, and spare parts moved over rural roads, while power, communications, water, sewage, drainage, and emergency systems had to support a self-contained underground installation.
The Orchard name refers to a former rural community and geographic association, not to an operating municipality that owned the missile site. Boise appears in postal, county, and modern location records. The history retains both terms because Orchard explains the Cold War identity and Boise helps locate the present parcel without erasing the historical name.
The nearby Orchard Combat Training Center is a large Idaho National Guard training landscape with a separate history, ownership pattern, and military mission. The evidence reviewed does not place parcel S2709336100 inside that training installation or show that the former missile complex became part of it. Geographic proximity is not treated as a property or command relationship.
Current private ownership and rural land use make access limits especially important. Public-road visibility, online coordinates, or a former military function do not create a right to enter. Deep shafts, altered floors, salvage damage, standing water, confined spaces, deteriorated materials, and unverified modifications can remain hazardous even where little appears on the surface.
The 9th Bombardment Wing provided the parent organization when the missile mission arrived. The Air Force redesignated it the 9th Strategic Aerospace Wing in April 1962 to reflect combined bomber, tanker, and missile responsibilities. Mountain Home's B-47 and KC-97 missions continued while the underground field entered service.
The construction contract was publicly opened in Boise on February 5, 1960. The Kaiser-Raymond-Macco-Puget Sound team submitted the low bid of about $28.9 million, and the Air Force announced award on February 9. Official Mountain Home history reports that field costs ultimately exceeded $51 million because of labor shortages, material shipment, weather, strikes, and continuing design changes. Those are field-wide figures, not a cost assigned to 569-C alone.
The 569th was the last Titan I squadron activated by Strategic Air Command. Its late place in the deployment sequence produced a short operating life, but the Orchard complex still entered full alert status, supported the national deterrent during the Cuban Missile Crisis, and remained an operating nuclear weapon installation until the 1965 phaseout.
The Mountain Home contract transferred to the Titan I Directorate of the Corps of Engineers Ballistic Missile Construction Office in October 1960. Official base history records deep water wells, severe weather, long material routes, labor shortages, strikes, and design changes across the field. Three construction workers died during the Idaho program. The reviewed source does not assign those deaths to a particular complex, so they remain field-wide facts.
The three Idaho sites were complete before April 1, 1962, but structural completion was not combat acceptance. Elevators, doors, guidance electronics, power systems, communications, liquid-oxygen equipment, alarms, launch consoles, and government-furnished missile equipment required installation, calibration, integrated testing, and crew training before alert duty.
No site-specific 569-C construction log, contractor progress album, or as-built plan was located. Standard Titan I drawings and the Historic American Engineering Record for Lowry Complex 2A provide strong design comparisons, but they do not prove every Orchard dimension, construction change, or later alteration. The history and graphics label those materials as standard design evidence rather than a 569-C survey.

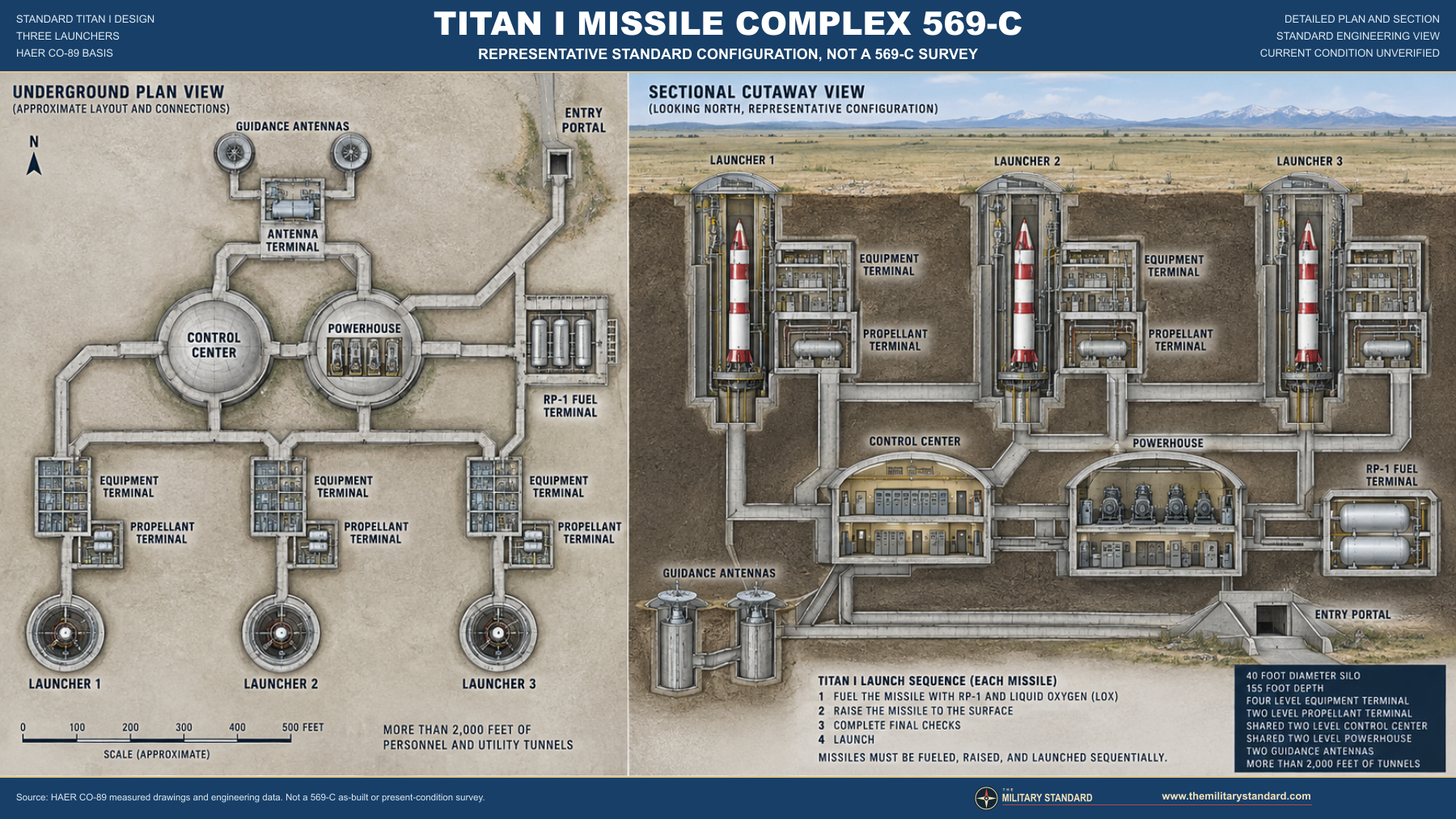

Standard Underground Design and Surface Layout The underground plant centered on a protected access route, launch control center, powerhouse, utility spaces, two guidance antenna silos, and connecting junctions. The control center housed command consoles, status displays, communications, authentication material, and crew working spaces. The powerhouse contained diesel generators and electrical distribution equipment so the complex could operate after loss of commercial power.
Three launcher branches extended from the central area. Each branch incorporated an equipment terminal, propellant terminal, connecting tunnels, and missile silo. The equipment terminal supported the launcher elevator and machinery. The propellant terminal handled RP-1 kerosene fuel and liquid-oxygen equipment. The missile remained below paired doors on an elevator and had to be fueled, raised into the open, and launched from the surface.
Two retractable guidance antennas occupied separate protected silos. Titan I carried inertial instruments but depended on radio corrections transmitted from the ground during early flight. Redundant antennas reduced the risk that a single failure would remove the guidance function. These were missile-guidance antennas, not air-search radar systems.
The HGM-25A Titan I was a two-stage liquid-propellant intercontinental ballistic missile about 98 feet long. Both stages used RP-1 and liquid oxygen. The cryogenic oxidizer could not remain loaded indefinitely, so alert procedures included fueling. Crews and maintainers monitored tanks, pumps, valves, lines, high-pressure gases, electrical power, hydraulics, doors, elevators, ventilation, and communications as one integrated weapon system.
Standard Titan I records describe three missiles per complex, a hardened control center, independent power, utility and cable tunnels, protected access, sewage and water systems, surface security fencing, patrol roads, launcher doors, antenna doors, vents, hatches, and survey features. The accompanying layout is a carefully sourced standard configuration. It is not a site-specific as-built plan or current condition map.
Propellant Loading Exercises tested each missile on a recurring cycle. These exercises verified lines, pumps, tanks, sensors, timing, communication, and emergency responses under conditions approaching a real countdown. A launch order required authenticated messages, two-person procedures, liquid-oxygen loading, guidance preparation, door operation, elevator movement, and surface ignition. Titan I was an enormous advance over aircraft-only deterrence, but the exposed fueling and elevation sequence helped drive the transition to Titan II and solid-propellant Minuteman systems.
The February 1960 award to the Kaiser-Raymond-Macco-Puget Sound team established the principal field construction organization. Federal oversight shifted in October 1960 to the Titan I Directorate of the Corps of Engineers Ballistic Missile Construction Office. This national organization was created because ordinary base-construction practice could not easily manage a missile design that was still changing while contractors built operational facilities across several states.
Design change was not a minor paperwork problem. A change to launcher doors, elevators, blast valves, electrical distribution, fuel or oxidizer equipment, communications, guidance, or environmental control could affect excavation, concrete placement, embedded conduit, equipment delivery, testing, and crew procedures. Rework increased cost and schedule pressure. The Mountain Home field's rise from an initial contract near $28.9 million to a final cost above $51 million belongs in that technical context.
Acceptance proceeded by systems and milestones. A structurally complete complex could still lack functioning doors, elevators, generators, guidance equipment, communications circuits, alarms, launch consoles, or tested missile hardware. Contractors demonstrated installed systems, engineers recorded deficiencies, Air Force activation teams conducted integrated tests, and operating crews trained on normal, emergency, and nuclear-surety procedures. The August 16, 1962 operational declaration was therefore the culmination of many turnovers rather than a single construction date.
The three field-wide construction deaths documented in official Mountain Home history show the human cost of the program. The available source does not assign them to Site C. They are not merged with the separately documented October 1967 salvage fatality, which occurred after military operations and is established by a published Idaho Supreme Court opinion.
Idaho's Titan field was publicly declared operational on August 16, 1962, during a ceremony involving Senator Len B. Jordan. The declaration applied to the Mountain Home field and squadron. The reviewed official and secondary sources do not prove that every technical acceptance action at 569-C occurred on that exact day, so the date is labeled as a field-level operational milestone.
Activation required far more than placing missiles into silos. Elevators, doors, oxidizer systems, power generation, environmental controls, guidance antennas, communications, alarms, security systems, and launch consoles had to function together. Crews practiced normal and emergency procedures while maintenance specialists resolved deficiencies.
The declared operational date came less than two months before the Cuban Missile Crisis. The short interval illustrates the speed with which the new force moved from construction into national alert responsibility. It also explains why precise distinctions among construction completion, contractor acceptance, Air Force turnover, operational declaration, first alert, and individual missile status are necessary.

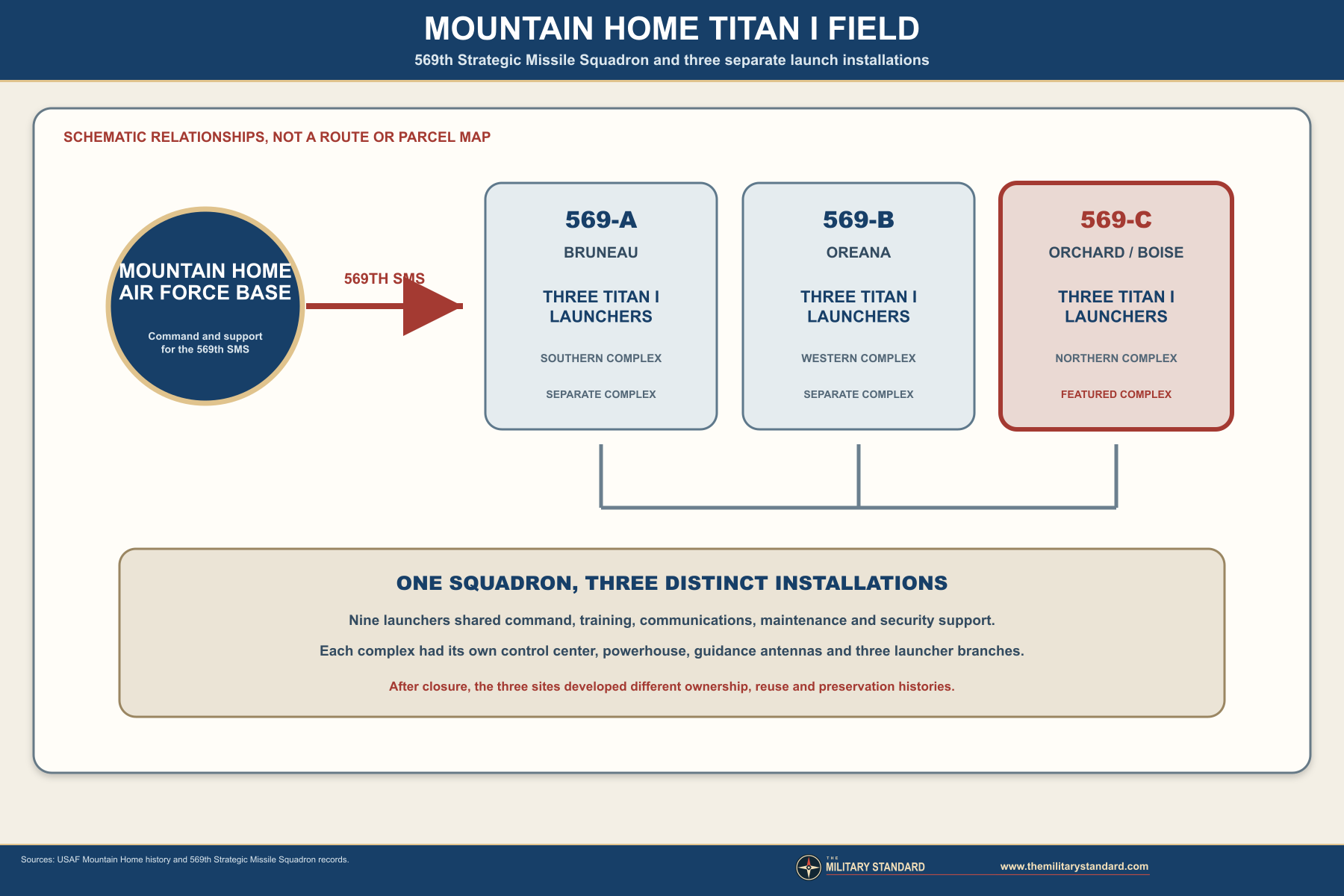

The squadron used a three-by-three deployment. Complexes 569-A, 569-B, and 569-C each held three launchers. A crew at Orchard controlled one complete three-missile complex, while squadron leadership, maintenance, security, communications, and parent-wing support connected the three remote installations to Mountain Home AFB.
Personnel trained in nuclear command and control, authentication, console procedures, liquid-oxygen safety, electrical and hydraulic systems, guidance, communications, security, fire protection, and emergency response. Titan I's labor-intensive design required extensive daily surveillance and periodic propellant-loading exercises.
The missile squadron was part of a broader Strategic Air Command installation. The 9th wing also operated alert bombers and tankers. The combined mission produced the 1962 Strategic Aerospace Wing designation, but Orchard remained a distinct remote launch installation rather than a section of the airfield property.
Shift turnover depended on disciplined records. Incoming personnel needed accurate launcher status, maintenance discrepancies, security conditions, communications checks, test schedules, and restrictions on equipment. Nuclear operations required controlled access, authentication procedures, two-person practices, and careful custody of classified and sensitive material. A missed discrepancy or casual shortcut could remove a launcher from alert or create a safety risk.
The underground environment required constant mechanical support. Ventilation controlled heat, humidity, fumes, and equipment conditions. Pumps managed water and drainage. Diesel generators and electrical switchgear provided backup power. Hydraulic systems moved massive doors and elevators. Water, sewage, lighting, communications, fire protection, and escape provisions protected personnel. The installation was hardened against attack, but daily reliability depended on ordinary maintenance performed to exceptional standards.
Remote location complicated emergency response. Fire, medical, security, propellant, confined-space, electrical, and mechanical emergencies demanded site procedures and coordination with the parent base. Liquid oxygen presented intense cold and compatibility hazards. RP-1, diesel fuel, lubricants, batteries, high-pressure gases, and electrical equipment added different risks. Training had to cover isolation, delayed outside assistance, and the possibility that several systems could fail during the same event.
Missile alert was repetitive by design. Crews watched indicators, tested circuits, authenticated messages, recorded status, and practiced emergency actions while hoping never to execute the combat mission. Maintenance teams inspected machinery that usually remained stationary but had to work immediately on command. The apparent quiet of a buried installation concealed a continuous cycle of surveillance, testing, documentation, repair, and certification.
The Orchard complex's strategic value came from readiness and dispersal, not visible activity. Its three missiles contributed to a nine-launcher squadron and a national force. The site deterred attack by convincing an adversary that buried, separated weapons and trained crews could survive long enough to retaliate. That purpose gives routine work, not only crisis events, a central place in the historical record.
The underground complex was designed to continue functioning after outside utilities failed. Diesel generation, stored supplies, filtered ventilation, protected communications, and hardened access supported survivability. Hardening did not make the installation invulnerable. Its dispersal, burial, blast-resistant construction, redundancy, and rapid launch sequence together sought to preserve retaliatory capability long enough to deter attack.
Titan I's cryogenic design placed a special burden on alert operations. Liquid oxygen could not remain indefinitely in the missile. A launch order would initiate a controlled sequence involving authentication, system checks, propellant loading, guidance preparation, silo-door operation, elevator movement, and surface launch. The need to raise the missile left the weapon exposed during the final sequence, one reason later Titan II and Minuteman systems emphasized in-silo launch and more readily stored propellants.
The radio-guidance system linked the missile to protected ground antennas. Inertial instruments provided basic navigation, while ground equipment calculated and transmitted corrections during early flight. That arrangement demanded reliable electronics, precise surveying, communication among subsystems, and functioning antenna machinery. Guidance was not an accessory. It was part of the operational weapon system.
The significance therefore lies in confirmed readiness rather than invented drama. Men at Orchard maintained a live intercontinental ballistic missile installation while national command authorities confronted Soviet missile deployment in Cuba. Communications, authentication, security, mechanical reliability, and disciplined adherence to procedure all carried immediate strategic importance. The site's purpose was deterrence, and the crisis tested whether that deterrent could be presented as credible without being used.
The powerhouse served as the site's mechanical heart. Multiple diesel generators, switchgear, batteries, hydraulic equipment, ventilation, pumps, and cooling systems allowed the complex to support missile readiness independent of ordinary utilities. Machinery also created maintenance demands and potential environmental sources. Fuels, lubricants, solvents, electrical components, sumps, drains, and wastewater systems later became part of the broader environmental inquiry at former missile sites.
Security began with remoteness, fencing, controlled gates, alarms, patrols, identification procedures, and armed response. It continued underground through protected portals and controlled areas. Modern private ownership and the visibility of large surface doors do not erase those historic layers, but neither do they make the site safe to enter. Deep shafts, decayed floors, unguarded openings, poor air, standing water, electrical remnants, and contaminated media can turn curiosity into a fatal hazard.
Maintenance was continuous because Titan I combined cryogenic propellant systems, high-pressure gases, mechanical elevators, heavy doors, guidance electronics, power generation, ventilation, and early command equipment. A failure in one component could remove a launcher from alert. Preventive maintenance, periodic tests, parts supply, contractor support, and disciplined documentation were as essential to readiness as the missile itself.
The Mountain Home field left alert during the nationwide 1965 drawdown. The 569th Strategic Missile Squadron was inactivated on June 25, 1965. Missiles, classified material, reusable equipment, wiring, and valuable metals were removed during decommissioning. Exact launcher-by-launcher alert termination dates for 569-C were not located and are not invented.
The federal government then treated the detached complex as surplus real property while contractors carried out salvage. Removal of machinery and metals changed the installation physically and created industrial hazards unrelated to normal missile operations. The process was neither an orderly museum conversion nor immediate abandonment.
The 1968 federal surplus-property report identified the installation as Mountain Home AFB, Air Force Facility S-3, Mountain Home, GSA control D-Idaho-457. It listed a reported cost of $18.849 million, but that accounting value should not be mistaken for the original construction contract or the final cost of the three-site Idaho field.
The court described a ten-foot wire-mesh fence topped with barbed wire and an installation containing three missile silos, a command bunker, underground tunnels, and storage areas. Titan Equipment controlled possession and access and employed five workers. By autumn 1967 it had been salvaging the complex for about five months.
In September 1967 Titan Equipment entered an arrangement with Roy Mays for labor and equipment, with compensation based largely on sharing removed salvage. Floyd Duane Adam worked for Mays. On October 20, 1967, Adam was killed when scaffolding collapsed while he was dismantling equipment at the former missile site.
The published decision concerned statutory employer responsibility under Idaho law. It is not a military accident report or a comprehensive occupational-safety investigation. Even so, it establishes the location, control, salvage activity, physical character, approximate timing, and fatality with much greater authority than later anecdotes about an abandoned silo.
Federal surplus reports add the property-accounting sequence. The December 31, 1968 inventory listed 310.08 acres, including 255.03 acres of easements. The December 31, 1969 report listed 255.03 acres, all described as easements. The disappearance of 55.05 non-easement acres from the later inventory strongly suggests a disposal or accounting transition, but the reports alone do not establish the grantee, exact deed date, or every retained right.
Later summaries state that the site passed into private ownership. The official 2026 Ada County parcel layer confirms private ownership of the 56.417-acre parcel containing the representative complex point.
Titan I complexes used diesel fuel, RP-1 kerosene, liquid oxygen, high-pressure gases, hydraulic fluids, lubricants, batteries, solvents, cooling and water-treatment chemicals, sewage systems, electrical equipment, and numerous industrial materials. Decommissioning and salvage introduced cutting, dismantling, falling-object, confined-space, and structural risks. The 1967 fatality confirms that postmilitary work itself was hazardous.
Site-specific claims require sampling reports, agency determinations, deeds, closure records, or professional inspections. Environmental findings from the Bruneau and Oreana complexes cannot be transferred to Orchard merely because the three sites shared a military design. Site A and Site B became regulated waste properties with separate records. Site C requires its own evidence.
Current and future investigators should treat deep shafts, weakened concrete, corroded steel, missing railings and floors, standing water, poor air, electrical remnants, buried utilities, salvage debris, and unknown fill or modification as potential hazards. These cautions are based on the installation type and salvage history. They are not a substitute for a site-specific engineering or environmental assessment.
A January 2007 Associated Press report described the property as private and noted a mobile home, vehicles, tires, earth mounds, and owners who declined access and photography. That report is a dated surface snapshot, not proof of the site's condition in 2026. It is useful because it confirms private residential or rural-property use and the difficulty of interpreting the former complex from outside the property.
Secondary visitor accounts report little distinctive equipment visible from the gate. Unofficial accounts also describe underground exploration, but such material does not establish permission, safety, exact date, completeness, or professional condition.
Reinforced-concrete structures may survive beneath altered ground, but exact accessibility, water levels, salvage completeness, structural integrity, and current modifications remain unverified. The former complex should be described as surviving in unknown and altered condition rather than intact, destroyed, flooded, or accessible.
Current use is best stated conservatively: private rural property on the footprint of a decommissioned missile complex, with a 2007 report of residential, vehicle, tire, and earthwork activity.
