Atlas F Site 579-10 sat west of Roswell, close enough to the city to belong to the Walker missile ring but far enough out on the U.S. Highway 70/380 corridor to feel like a hidden Cold War machine in open desert. Its short missile career lasted only a few years, but the paper trail it left behind is unusually clear: Site 10 can be followed from emergency Atlas construction, to armed Strategic Air Command alert, to the 1965 Atlas phaseout, to federal land disposal, to environmental investigation, cleanup, and an EPA/New Mexico/Corps of Engineers Ready for Reuse determination.
Atlas F Site 579-10 was an SM-65F Atlas intercontinental ballistic missile launch complex assigned to Walker Air Force Base near Roswell, New Mexico. It belonged to the 579th Strategic Missile Squadron, under the 6th Bombardment Wing, later the 6th Strategic Aerospace Wing. The site code was 579-10. Its missile system was the SM-65F Atlas, the final operational Atlas ICBM variant and the model deployed in hardened vertical silo-lift launch complexes.
Because Site 579-10 was an Atlas F complex, it did not have a separate Minuteman-style remote parent Launch Control Center. An Atlas F launch complex contained its own launch control center on site, connected to the missile silo by an underground tunnel.
EPA's Ready for Reuse determination states that construction of the missile launching facility was completed in November 1961. The site is no longer active as a military installation. It is a decommissioned former Atlas F launch complex, former federal property, private/no-public-access property, and a former FUDS/DERP environmental site whose surface property received a Ready for Reuse determination on 2009-09-16.

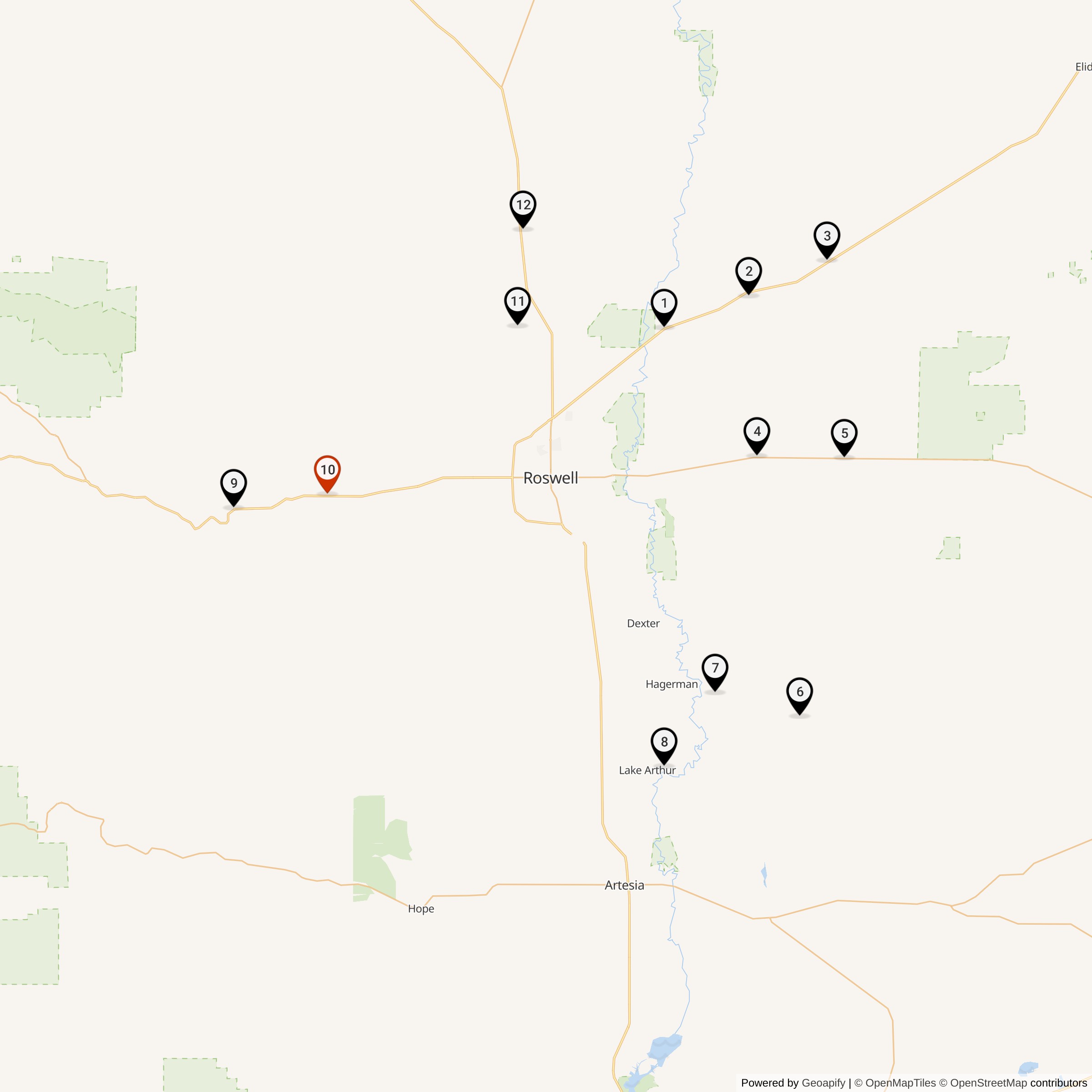

That landscape mattered. The twelve Walker Atlas F launch complexes were dispersed around Roswell so that no single attack could destroy the entire squadron. Walker Air Force Base provided headquarters, aircraft and missile support, maintenance, security, transportation, supply, communications, and weapons-support infrastructure, but the missiles themselves were pushed outward into individual hardened complexes. Site 579-10 helped extend the Walker missile ring to the west, away from the base and away from the Pecos Valley sites southeast of Roswell.
The physical Atlas F complex was much more substantial than a simple underground tube. A 1962 Walker Atlas F tour bulletin described the standard Walker launching facility as consisting of a launching silo, a launch control center, and an underground connecting tunnel. The silo had an inside radius of 26 feet, 1 inch, meaning an inside diameter of roughly 52 feet, 2 inches, and extended about 178 feet deep. The launch control center had a 40-foot inside diameter. The silo walls were 2 feet, 6 inches thick near the upper section and flared to a total wall thickness of 9 feet lower down. The missile and associated equipment were carried in a steel crib suspended from shock mounts inside the silo, and the launch control center used suspended floors for equipment and crew spaces. These features reflected the Atlas F requirement for blast resistance, shock isolation, and survivable launch control.

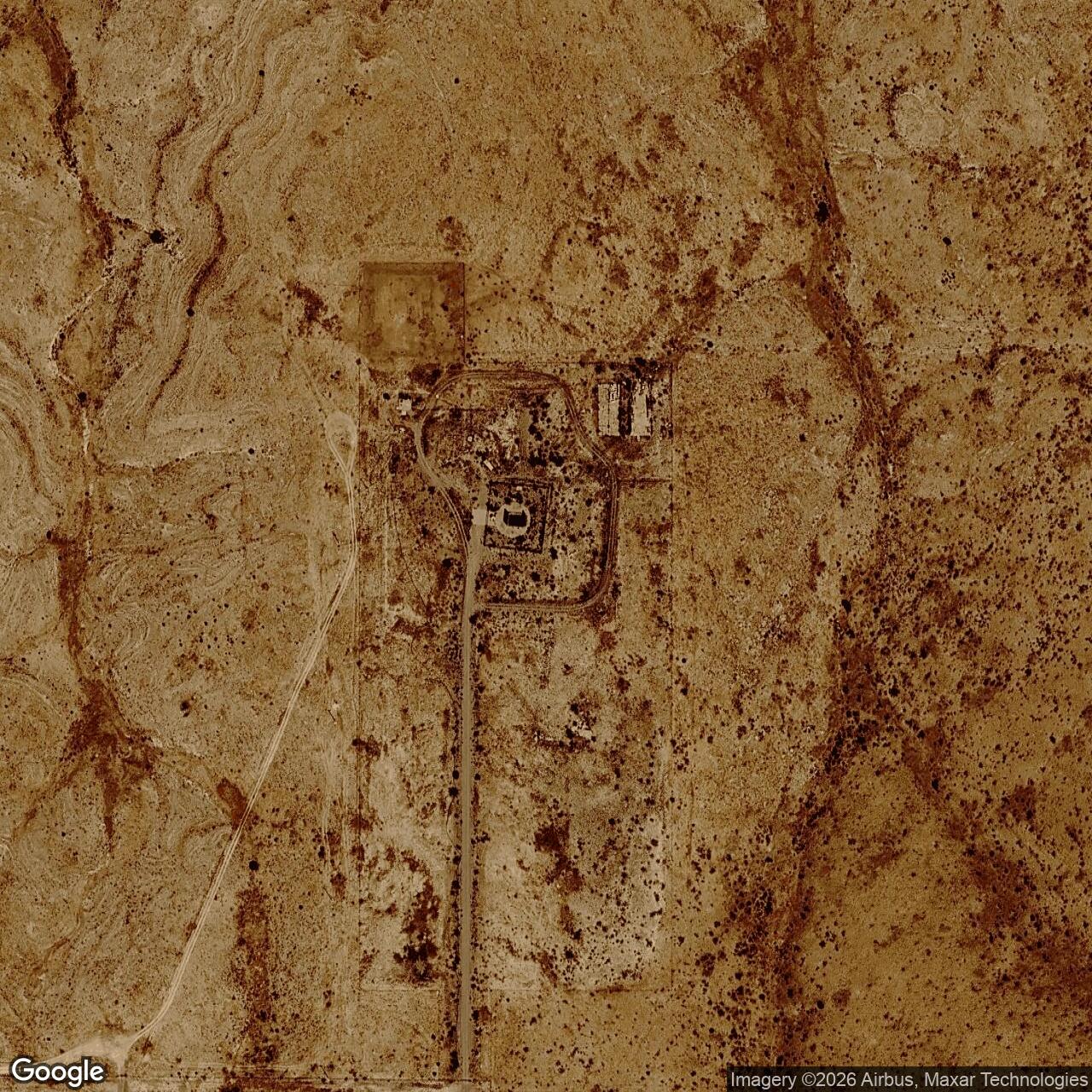

Above ground, Site 579-10 would have included the elements typical of an Atlas F launch complex: access road, security fencing, surface entries, ventilation and utility features, antennas or communications-related equipment, parking and hardstand areas, power and support structures, and the large silo-door area above the launcher. Satellite images of the former complex footprint shows the surviving disturbed pad and fenced central feature in an arid setting, with rectangular surface scars and access traces that reflect the site's former military-engineering layout.
The Atlas F was the most advanced operational Atlas variant. Unlike Atlas D gantry and coffin-launcher arrangements and Atlas E semi-hardened coffin sites, Atlas F was stored vertically underground in a hardened silo-lift complex. The National Park Service summarizes Atlas F as an 82-foot missile held in a blast-proof silo-lift configuration and capable of launch in approximately ten minutes. Seventy-two Atlas F missiles were deployed at six bases, including twelve at Walker Air Force Base in New Mexico.
Site 579-10 was therefore not a local defense site for Roswell. It was part of a national nuclear deterrent. Its rural location, hardened silo, buried launch control center, communications systems, security perimeter, and separation from the other eleven Walker sites all served the same strategic goal: dispersal and survivability. The site existed to make the Walker Atlas force harder to destroy and to give Strategic Air Command another launch complex capable of supporting a retaliatory strike if ordered by national command authority.
The phrase "operational launch-ready alert posture" requires careful explanation for Atlas F. It did not mean that the missile was continuously raised above ground. It also did not mean that the missile was continuously loaded with liquid oxygen. In normal alert conditions, the Atlas F sat vertically underground on its elevator launcher. RP-1 fuel was kept aboard. The missile and facility were maintained in readiness, and the missile's pressurization, electrical, propellant, environmental, communications, and safety systems had to be monitored. Launch crews, maintenance teams, and security forces supported the site through the squadron structure. Liquid oxygen would be loaded as part of the launch sequence. The silo doors would open, the launcher would raise the missile, and the crew could top off liquid oxygen during a short hold before the final launch command. During a crisis, readiness meant that crews, communications, propellant systems, facility systems, security, and missile hardware were brought to the highest practical state of serviceability within the limits of the Atlas F design. It did not mean a continuously exposed or continuously LOX-loaded missile waiting above the silo.
Design began in early March 1960. The project was advertised for bids on 1960-05-16, bids were opened on 1960-06-15, and the construction contract was awarded on 1960-06-16. The $22,125,828 contract went to a joint venture of Macco Corporation, Raymond International, Inc., The Kaiser Company, and Puget Sound Bridge & Dry Dock Company. Notice to proceed followed on 1960-06-20, and work began on 1960-06-23. The Corps' Roswell Area Office, activated on 1960-05-15, supervised the missile construction effort as the Air Force's construction agent.
Site 579-10 was built under this program as Corps of Engineers Construction Site Number 7. EPA later reported that the Department of Defense acquired 390.51 acres of property in 1960 and that construction of the missile launching facility was completed in November 1961.
The Corps tour bulletin gives a rare glimpse of what this construction meant at the individual-site level. Open-cut excavation first created a mass excavation approximately 38 feet deep, large enough to construct the silo, launch control center, work space, and access ramp. The silo shaft then went down to approximately 178 feet below the original ground surface. Crews drilled and blasted the shaft, removed broken material by cranes, clam buckets, muck buckets, and trucks, and installed containment using wire mesh, gunite, steel ring beams, and lagging where water seepage required it.
The concrete work was enormous. The Corps estimated that roughly 48,000 cubic yards of material were removed by open-cut excavation and another 24,000 cubic yards by silo shafting, for about 72,000 cubic yards of excavation per site. Approximately 6,000 cubic yards of concrete were placed per site. The steel crib alone weighed about 600 tons; when the crib, fueling vessels, motor generators, propellant-loading skids, and other equipment were suspended and balanced, the suspended system weighed about 1,800,000 pounds. The construction process was also unusually demanding because the propellant-loading system had to meet strict cleanliness requirements. The Corps bulletin warned that foreign material, especially hydrocarbons, could cause violent explosion and interfere with facility function.
The missile assigned to Site 579-10 was Atlas 85F. Its General Dynamics missile serial number was 61-2571, its Air Force missile tail number was 571, its acceptance date was 1962-06-18, and its delivery date was 1962-06-26. The missile was assigned to the 579th Strategic Missile Squadron at Walker Air Force Base and to Site 10.
The Atlas F complex was designed so that the missile remained vertical underground. During alert, the missile sat in the silo-lift launcher, protected by massive overhead doors. When ordered through a valid launch sequence, the missile would be loaded with liquid oxygen, raised to the surface, locked into launch position, and fired. The launch control center was inside the same complex, connected to the silo by the underground tunnel. Unlike later Minuteman launch facilities, Site 579-10 was not an unmanned silo controlled only from a remote launch control center. Atlas F sites had on-site launch control and facility equipment, while the squadron and parent base supplied the crews, maintenance, security, logistics, and command structure that kept the site on alert.
Site 579-10's daily operational life was defined by readiness rather than launch. Crews had to monitor and maintain a liquid-fueled missile, a deep underground launcher, a hardened launch control center, power systems, propellant systems, communications, security systems, environmental-control equipment, and strict safety procedures. The site was part of a larger missile field whose facilities were manned and supported continuously while the squadron was active. The work was repetitive, technical, and unforgiving. Atlas F's liquid oxygen, high-pressure systems, RP-1 fuel, missile pressurization needs, and propellant-loading equipment made readiness a constant engineering and safety problem.
During the Cuban Missile Crisis in October-November 1962, the 579th Strategic Missile Squadron's operational sites were held at a high level of alert. For Site 579-10, the individual site-level evidence is not precise enough to say exactly what occurred at the complex on each day of the crisis, but the squadron history states that operational 579th sites were ready to launch if necessary. That should be understood in the Atlas F sense: the site and missile were maintained for launch readiness, not left continuously raised or continuously loaded with liquid oxygen.
The Walker Atlas F field also had a troubled operational record. Three of the twelve Walker sites were lost to explosions: Site 579-1 on 1963-06-01, Site 579-5 on 1964-02-13, and Site 579-2 on 1964-03-09. Those were sister-site events, not Site 579-10 events, but they shaped the operating environment for every 579th Strategic Missile Squadron crew. They demonstrated the hazards of first-generation liquid-fueled missile operations, especially in deep hardened complexes whose propellant and pressurization systems demanded exact procedures and constant discipline.
EPA's Ready for Reuse determination provides unusually specific disposal details for Site 10. It states that DOD announced in May 1964 that the Atlas F missile program would be phased out. In July 1965, Site 10 was declared excess to the General Services Administration. In January 1967, 300.91 acres were returned to the Bureau of Land Management by Public Land Order 4137. In April 1968, GSA conveyed the remaining 89.60 acres in fee simple to Robert G. Wolfson. EPA identified the current owner in 2009 as Mr. Keary A. Olson.
The former launch complex should be treated as private property and a potentially hazardous former military-industrial site. Former Atlas F complexes can include deep underground structures, confined spaces, water hazards, deteriorated concrete and metal, hidden openings, and environmental-remediation areas. No public access was identified in the reviewed sources. Any visit would require explicit landowner permission and appropriate safety controls.
