Atlas F Site 579-9 sat where the Roswell missile field reached west into the harsher country near Picacho. It was built for a moment when the United States wanted nuclear missiles hidden in hardened concrete silos, dispersed far from their parent base, ready to be brought through an exacting liquid-oxygen launch sequence on short notice. But Site 579-9 also tells the afterlife story of the Atlas program unusually well: after the missile years ended, the federal government sold the property, environmental investigators studied the underground tank area, sump outfall, and septic leachfield, and EPA, the New Mexico Environment Department, and the U.S. Army Corps of Engineers later issued a Ready for Reuse determination for the surface property.
Atlas F Site 579-9 was an SM-65F Atlas intercontinental ballistic missile launch complex assigned to Walker Air Force Base near Roswell, New Mexico. It belonged to the 579th Strategic Missile Squadron, under the 6th Bombardment Wing, later the 6th Strategic Aerospace Wing. The site code was 579-9. Its missile system was the SM-65F Atlas, the final operational Atlas ICBM variant and the model deployed in hardened vertical silo-lift launch complexes.
Because Site 579-9 was an Atlas F complex, it did not have a separate Minuteman-style remote parent Launch Control Center. An Atlas F launch complex contained its own launch control center on site, connected to the missile silo by an underground tunnel.

That isolation was part of the point. The twelve Walker Atlas F launch complexes were dispersed around Walker Air Force Base so that no single attack could destroy the entire squadron. Site 579-9 helped spread the 579th Strategic Missile Squadron's missile force into a broad ring around Roswell. Walker Air Force Base provided headquarters, maintenance, security, transportation, supply, communications, and weapons-support infrastructure, but the actual missiles were deliberately separated from the base and from each other.
The physical Atlas F complex was much more substantial than a simple underground tube. A 1962 Walker Atlas F tour bulletin described the standard Walker launching facility as consisting of a launching silo, a launch control center, and an underground connecting tunnel. The silo had an inside radius of 26 feet, 1 inch, meaning an inside diameter of roughly 52 feet, 2 inches, and extended about 178 feet deep. The launch control center had a 40-foot inside diameter. The missile and associated equipment were carried in a steel crib suspended from shock mounts inside the silo, and the launch control center also used suspended floors. These design features reflected the Atlas F requirement for blast resistance, shock isolation, and survivable launch control.

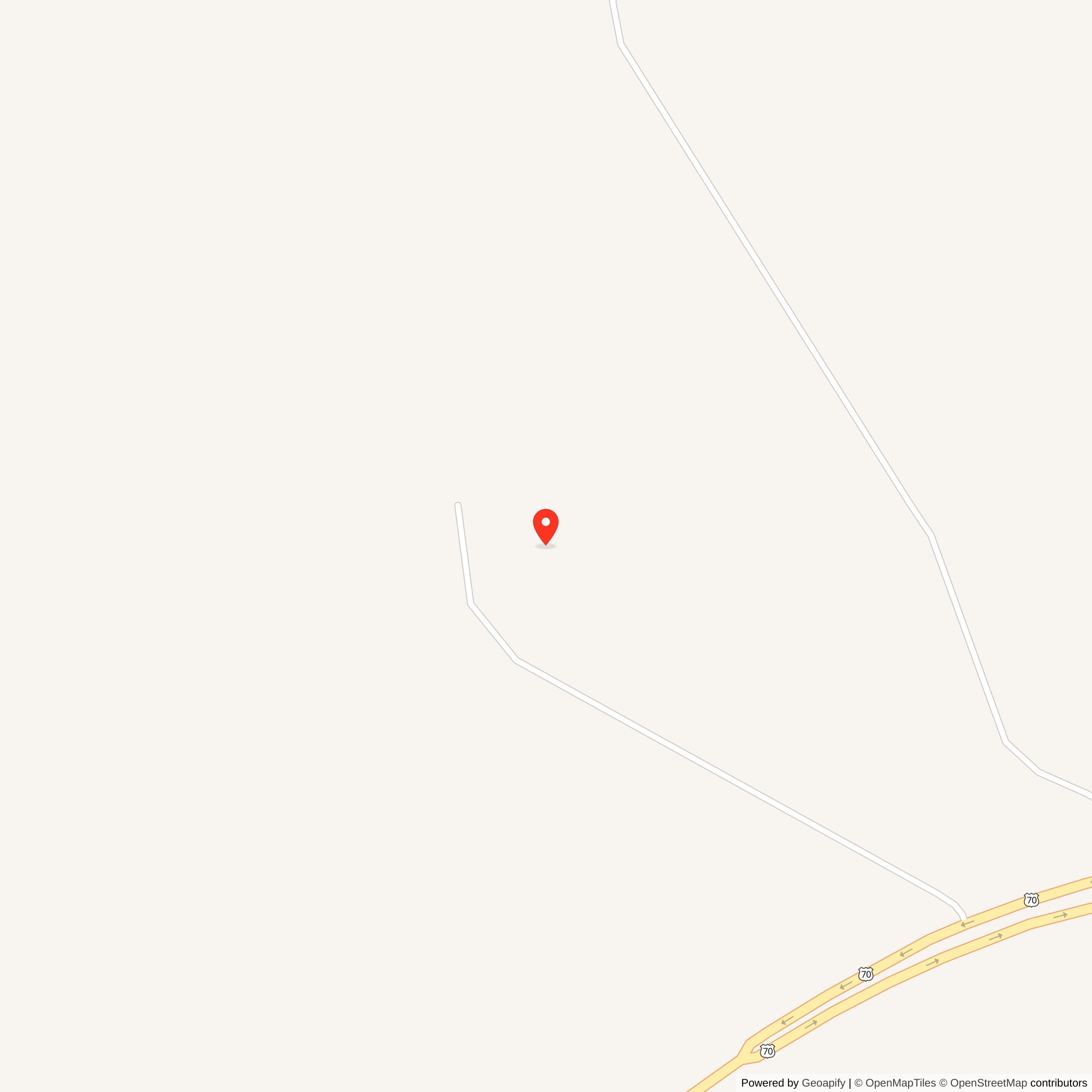

Above ground, Site 579-9 would have included the elements typical of an Atlas F launch complex: access road, security fencing, surface entries, ventilation and utility features, antennas or communications-related equipment, parking and hardstand areas, power and support structures, and the large silo-door area over the launcher. Satellite images show the former complex footprint near Picacho. The visible pattern is characteristic of a former Atlas F site: disturbed rectangular surface area, the circular silo-related feature, access traces, and remnants of the support layout.
The Atlas F was the most advanced operational Atlas variant. Unlike Atlas D gantry and coffin-launcher arrangements and Atlas E semi-hardened coffin sites, Atlas F was stored vertically underground in a hardened silo-lift complex. The National Park Service summarizes Atlas F as an 82-foot missile held in a blast-proof silo-lift configuration and capable of launch in approximately ten minutes. Seventy-two Atlas F missiles were deployed at six bases, including twelve at Walker Air Force Base in New Mexico.
Site 579-9 was therefore not a local defense site for Picacho or Roswell. It was part of a national nuclear deterrent. Its rural location, hardened silo, buried launch control center, communications systems, security perimeter, and separation from the other eleven Walker sites all served the same strategic goal: dispersal and survivability. The site existed to make the Walker Atlas force harder to destroy and to give Strategic Air Command another launch complex capable of supporting a retaliatory strike if ordered by national command authority.
The phrase "operational launch-ready alert posture" requires careful explanation for Atlas F. It did not mean that the missile was continuously raised above ground. It also did not mean that the missile was continuously loaded with liquid oxygen. In normal alert conditions, the Atlas F sat vertically underground on its elevator launcher. RP-1 fuel was kept aboard. The missile and facility were maintained in readiness, and the missile's pressurization, electrical, propellant, environmental, communications, and safety systems had to be monitored. Launch crews, maintenance teams, and security forces supported the site through the squadron structure. Liquid oxygen would be loaded as part of the launch sequence. The silo doors would open, the launcher would raise the missile, and the crew could top off liquid oxygen during a short hold before the final launch command. During a crisis, readiness meant that crews, communications, propellant systems, facility systems, security, and missile hardware were brought to the highest practical state of serviceability within the limits of the Atlas F design. It did not mean a continuously exposed or continuously LOX-loaded missile waiting above the silo.
Design began in early March 1960. The project was advertised for bids on 1960-05-16, bids were opened on 1960-06-15, and the construction contract was awarded on 1960-06-16. The $22,125,828 contract went to a joint venture of Macco Corporation, Raymond International, Inc., The Kaiser Company, and Puget Sound Bridge & Dry Dock Company. Notice to proceed followed on 1960-06-20, and work began on 1960-06-23.
Site 579-9 was one of twelve Atlas F launch complexes in that Walker construction program. It was Corps of Engineers Construction Site Number 6. EPA's Ready for Reuse determination states that the U.S. government acquired multiple tracts of land for development of Silo Site 9 from the State of New Mexico between May 1960 and August 1962. Of the 333.28 acres acquired by the Department of Defense for Site 9 development, the actual missile facility occupied 5.48 acres, 234 acres were withdrawn from the public domain, and 93.8 acres were acquired through easements. EPA states that construction of the missile launching facility was completed in October 1961.
The 579th Strategic Missile Squadron was organized at Walker Air Force Base on 1961-09-01. Public sources do not provide a precise day on which Site 579-9 itself was accepted or placed on alert. Squadron-level material gives 1962-11-30 as the date associated with turnover to Strategic Air Command and operational status. In practical terms, Site 579-9 became part of the Walker Atlas F operational system during the 1962 buildup of the 579th Strategic Missile Squadron.
The Atlas F silo-lift system defined Site 579-9's technical role. The missile was stored vertically underground, protected by the hardened silo. In a launch sequence, the silo doors would open and the elevator launcher would raise the missile to the surface before firing. This was not a "hot launch" from inside the silo. It was a lift-to-launch design, an intermediate step between exposed launch pads and later missiles that remained fully underground until launch.
The site itself was not normally a large barracks or continuously crewed base. The launch control center was part of the individual launch complex, and the launch crew worked from the buried control center when the site was on alert. Maintenance personnel, propellant teams, communications specialists, security police, and other support personnel came to the site as needed from the squadron and base support structure. The site depended on Walker Air Force Base for supply, command, heavy maintenance, security organization, training, and overall missile-field support.
The sites assigned missile was General Dynamics missile serial number 61-2562, manufacturing number 76F, Air Force missile tail number 562. The missile was accepted on 1962-05-25 and delivered on 1962-06-08. After its operational ICBM service, the same missile later entered the ABRES test program. Missile 76F launched successfully from Vandenberg Air Force Base's Gantry A-2 on 1971-08-06, carrying an ABRES OV1-20 / OV1-21 payload, it was the last Atlas missile launched from the Vandenberg A-2 gantry complex.
For Atlas F crews, alert duty involved more than waiting for an order. The site had to keep a complex liquid-fueled missile, a buried launch control center, a deep silo, an elevator launcher, safety systems, environmental systems, and communications systems functioning under tight readiness standards. RP-1 fuel, cryogenic liquid oxygen support systems, missile pressurization, electrical readiness, ground-support equipment, and command-and-control links all mattered. Security personnel had to control access to a remote nuclear launch complex. Maintenance and propellant personnel had to work with hazardous materials in an environment that combined ordinary rural isolation with extraordinary strategic importance.
The Cuban Missile Crisis in October 1962 came as the Walker Atlas F force was moving into operational status. The 579th squadron's Atlas missiles were placed in an operational launch-ready alert posture during the crisis. For an Atlas F site such as 579-9, that meant the missile and facility were held at the highest practical readiness state, launch crews and support personnel were prepared for rapid action, communications and command links were maintained, security was heightened, and propellant and launch-support systems were readied for the launch sequence. It did not mean the missile was continuously raised above the silo, and it did not mean continuous liquid-oxygen loading.
The Walker Atlas F field also had a sobering safety history. Three sister sites in the same squadron were destroyed in propellant-loading explosions: Site 579-1 on 1963-06-01, Site 579-5 on 1964-02-13, and Site 579-2 on 1964-03-09. These were not Site 579-9 accidents. Their relevance is that they show the hazards of the Atlas F operating environment at Walker: large quantities of propellant and oxidizer, complex ground-support systems, deep silo structures, and high-pressure Cold War readiness all existed in close proximity.
For the 579th Strategic Missile Squadron, phaseout came early in 1965. Prior histories and source compilations for the Walker field identify 1965-01-05 as the date the first 579th SMS ICBM was taken off alert, 1965-02-04 as the date the last 579th SMS ICBM was taken off alert, and 1965-02-09 as the date the last 579th SMS ICBM was shipped. The larger Atlas F force then disappeared from operational SAC service as the first-generation Atlas system left the inventory.
The post-service property record for Site 579-9 is unusually specific. EPA states that in May 1964 the Department of Defense announced that the Atlas F missile program was to be phased out. In February 1966, Site 9 was declared excess to the General Services Administration. Bonham Farm Inc. purchased the property from GSA in March 1968. EPA's determination does not document the complete physical disposition of the underground launch equipment, missile removal from the complex, sealing details, or any later private modifications to the silo, launch control center, tunnel, or surface structures.
Site 579-9 was not a Strategic Arms Reduction Treaty demolition site in the later Minuteman or Peacekeeper sense. Its deactivation preceded the START-era ICBM silo elimination procedures. Its post-military history instead belongs to Cold War base closure, federal property disposal, environmental investigation, and surface-property reuse.
EPA's 2009 Ready for Reuse certificate states that the former Atlas Missile Silo Site 9 surface property was determined ready for reuse and that environmental conditions on the surface property were protective for current and anticipated future use as an industrial operation. This determination applies to the surface property and the environmental record reviewed by EPA, NMED, and USACE. It does not mean the underground missile structures are safe for public exploration, and it does not grant public access.
Former Atlas F sites may contain dangerous underground structures, confined spaces, standing water, old utilities, debris, unstable openings, and residual industrial hazards. EPA's Site 9 determination specifically notes that groundwater was not encountered within the study boundary to 250 feet below ground surface and that there was no water in the silo at the time of the site investigation reporting.
Publicly available imagery shows that the former complex remains physically legible. The image shows the former missile-site footprint and the circular silo-related feature within a rural landscape. The current day-to-day use, ownership beyond the documented Bonham Farm Inc. purchase, and condition of underground structures were not independently reverified from county records.
